Visit the My Arlington map to learn about other projects in your area
Late this summer, the South Walter Reed Drive Complete Streets project will begin work on South Walter Reed Drive between 5th Street South and Columbia Pike.
Project Goals
This project will redesign the surface of South Walter Reed Drive to better balance the needs of bike, pedestrian, vehicle and transit travel.
This project will include:
- Realignment of and addition of a signal to the intersection of 9th Street South
- Improved pedestrian crossings and add protected bike lanes on both sides of S. Walter Reed Dr.
- Improved bus stops within the project area and install a bus stop island at the 9th St. S. intersection.
- Reconfigured stormwater utilities
- New trees and landscaping strips
What to Expect During Construction
The first activity of the project will realign and add a signal to the intersection of South Walter Reed Drive and 9th Street South. This work will involve demolition of the center medians, repaving the street and installing new street markings.
The project will also coordinate with Arlington Public School's Grace Hopper Center construction project on South Walter Reed Drive, and the nearby Columbia Pike Multimodal Improvements project.
Stay Informed
The project schedule is still under development, but it is expected to be completed in mid- 2027. Stay informed of project updates on the project page and this newsletter. To stay informed of bus impacts, sign up for ART alerts and Metrobus alerts.
|

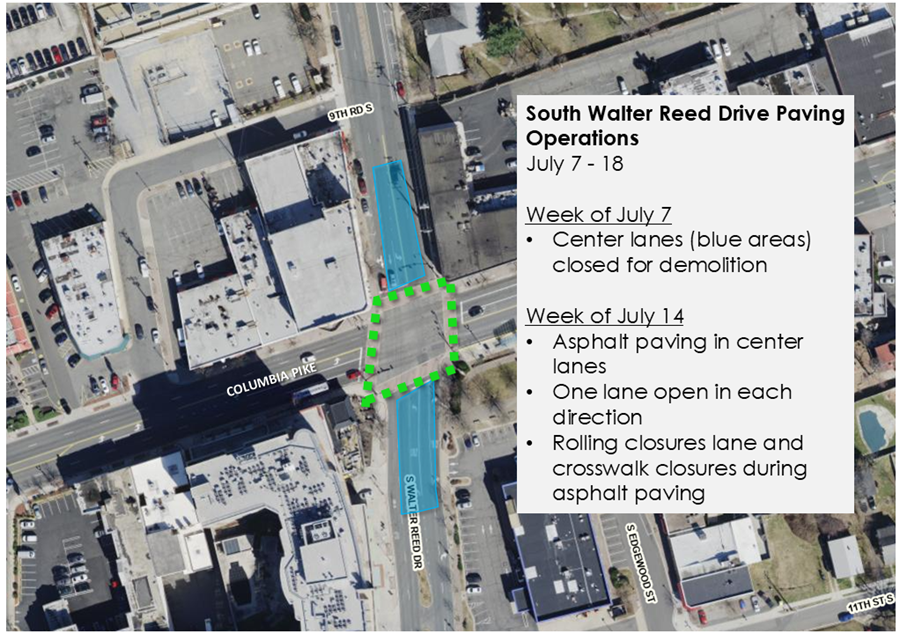

Beginning the week of July 7, construction crews will begin demolishing the center lanes along S Walter Reed Drive to the north and south of Columbia Pike.
This demolition is in preparation for the asphalt paving in the center lanes, which will begin on Monday, July 14 and continue through Friday, July 18. One lane in each direction will remain open on South Walter Reed Drive at all times.
- Center lanes along South Walter Reed Drive will be barricaded until repaving is complete.
- Police officers will help direct traffic through the intersection beginning Wednesday, July 9.
- During asphalt paving, there will be rolling lane and crosswalk closures and temporary turn restrictions through the intersection.
- All cross-traffic lanes on Columbia Pike will remain open.
Learn more on the Segment D page.
Join Arlington County staff for an update about the Columbia Pike Multimodal Project this Thursday, July 10, hosted on Teams.
Attendees will learn about:
- The project timeline, and when construction is expected to end in late 2025
- Project history, and what's been completed so far
- What Columbia Pike will look like after construction is over
- How to stay connected with project updates
Visit the event page to access the Teams link, ask questions in advance, and to get a calendar plug-in. A recording of the open house will be available after the event.
|

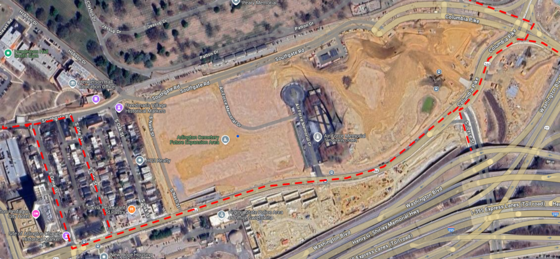

A new pedestrian route is in effect around the Southern Expansion Project site. Signs and fencing are in place to guide you. Follow the red dashed line in the image below to follow the detour.
If you're heading eastbound: Use South Orme St. or South Ode St. from Southgate Rd., then turn east on Columbia Pike to reach your destination.
If you're heading westbound: Use Columbia Pike heading west, then turn north on South Orme St. or South Ode St. From there, turn west on Southgate Rd. to reach your destination.
For your safety, do not use Southgate Rd (between South Ode St. and Old Columbia Pike) as a pedestrian route. This section of the road is now closed.
As always, ANC appreciates your patience and understanding. ANC will continue to provide you with significant updates. You can also find these notifications on the Southern Expansion Project page.
Questions? Please contact us at usarmy.anc.southernexpansion@army.mil.
The transportation team has received a number of common questions, so we're sharing the answers in our newsletter for everyone to learn together.
Question: Why are there new glass bus shelters on some stops on Columbia Pike, and black bus shelters on others?
Answer: The Columbia Pike Transit Shelter project is replacing old shelters with new glass shelters that include artwork by Spencer Finch inspired by the Columbia Pike community.
Road construction includes building the foundations and bus pads for the new shelters. The remaining shelters will be installed after road construction is done later this year.
|
Crews will replace and upgrade a portion of a sanitary sewer main at South Glebe Road from 14th Street South to 15th Street South starting Monday, July 14.
Here’s what you need to know:
-
Work hours: 9 a.m.- 4 p.m., Monday-Friday
-
Estimated duration: 4 weeks (through early August) weather permitting
-
Traffic impacts: Temporary closures of the left lanes in each direction on South Glebe Road, with one lane remaining open to northbound and southbound traffic.
-
Parking restrictions: Temporary “No Parking” signs will be in effect on segments of 14th Street South and 15th Street South near South Glebe Road to allow for staging of equipment, which the contractor will mobilize starting July 10.
Residents and people transiting through the area should expect these impacts in addition to dust and noise while the work is in progress.
Please contact the Water and Sewer Control Center with any questions at 703-228-5000.
|
 |
|
Starting August 1, prices for Capital Bikeshare will change to keep up with e-bike service demand across the region.
The biggest changes will be in the annual membership upfront price, and the by-the-minute rate for e-bikes.
See the full update.
|
|
